Quick Summary :-
Unclear ownership across setup phases often leads to missed deadlines and costly rework. This guide breaks down the complete GCC setup timeline, covering key milestones, dependencies, compliance, talent planning, and proven practices for building a scalable Global Capability Center.Execution delays, fragmented planning, and compliance challenges can slow a GCC launch before operations even begin. A structured setup timeline helps enterprises coordinate strategy, location selection, legal approvals, infrastructure, talent acquisition, knowledge transfer, and go-live within realistic timelines.

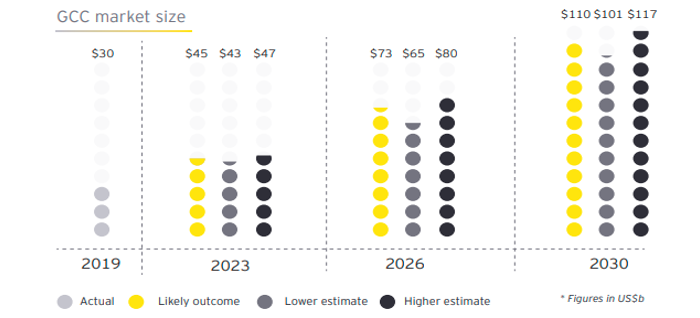

The opportunity continues to grow as India now hosts over 1,700 Global Capability Centers employing 1.9 million professionals, while the sector is projected to reach USD $105 billion by 2030 with nearly 2,400 GCCs and over 2.8 million professionals. Understanding every phase of the setup journey helps organizations reduce execution risks, improve planning, and establish a scalable, high-performing Global Capability Center.
What is a GCC Setup Timeline?
A GCC setup timeline is a phased roadmap that outlines how an organization moves from idea to execution. It typically spans 6 to 12 months, covering strategy, legal setup, infrastructure, hiring, knowledge transition, and operational stabilization.
Rather than a linear checklist, the timeline involves parallel workstreams – legal, HR, IT, finance, and leadership running simultaneously. Companies that understand these overlaps can significantly shorten their go-live window without compromising governance or quality.
GCC vs Outsourcing: Key Differences
Here are the major differences that help you decide faster-
| Factor | GCC (Global Capability Center) | Traditional Outsourcing |
| Ownership | Fully owned by parent company | Third-party vendor |
| Control | High (process, IP, talent) | Limited |
| Talent | Dedicated, long-term teams | Shared resources |
| Strategy | Core & innovation-focused | Task-based |
| Scalability | High, predictable | Vendor-dependent |
Overview: Typical GCC Setup Duration
Here is a brief overview that helps to define your objectives-
| GCC Size | Team Strength | Estimated Timeline |
| Small GCC | 20–50 employees | 4–6 months |
| Mid-size GCC | 50–200 employees | 6–9 months |
| Large GCC | 200+ employees | 9–12+ months |
The final duration depends on the GCC operating model, country regulations, talent complexity, and readiness of headquarters for global integration. Here is the explanation-
Phase 1: Strategic Planning & Business Case (Weeks 1–4)
Purpose of This Phase
This phase defines why the GCC exists and what success looks like. Without clarity here, later execution often suffers from scope creep and misalignment.
Key Activities
- Define GCC objectives (cost optimization, innovation, scale, resilience)
- Identify functions to be offshored (engineering, analytics, finance, support)
- Build a detailed cost-benefit analysis
- Establish success metrics and KPIs
- Align executive sponsorship and governance
Deliverables
- GCC vision and charter
- Financial business case
- High-level operating model
- Executive steering committee
Best Practice: Strong GCCs begin with long-term strategic intent, not short-term cost arbitrage.
Also Read: Cost of Setting Up a Global Capability Center (GCC) in India
Phase 2: Location & Operating Model Selection (Weeks 3–6)
Why This Phase Matters
Choosing the wrong location or operating model can delay go-live, inflate costs, and affect talent retention.
Location Selection Criteria
- Talent availability and skill depth
- Cost-to-quality ratio
- Regulatory environment
- Infrastructure maturity
- Time zone alignment
Common GCC Operating Models
- Captive Model: Fully owned and operated
- Build Operate Transfer (BOT): Partner builds, then transfers ownership
- Hybrid Model: Captive core with managed services support
Deliverables
- Final country and city selection
- Chosen operating model
- Risk and compliance assessment
Best Practice: Many enterprises use BOT models to accelerate setup while retaining long-term ownership.
Phase 3: Legal, Compliance & Entity Setup (Weeks 5–10)
Scope of This Phase
This phase establishes the legal foundation of the GCC and often becomes a critical path item.
Key Activities
- Company registration and entity incorporation
- Tax structure and transfer pricing setup
- Employment and labor law compliance
- Data protection and IP security policies
- Banking, payroll, and statutory registrations
Deliverables
- Registered legal entity
- Tax and compliance framework
- Employment contracts and HR policies
Common Risk: Underestimating local compliance timelines can delay hiring and office setup.
Phase 4: Infrastructure & Technology Setup (Weeks 7–14)
Infrastructure Focus Areas
This phase ensures the GCC is operationally ready to support secure, scalable delivery.
Key Activities
- Office space selection or temporary workspace
- Network, VPN, and access controls
- Cloud, DevOps, and toolchain integration
- Cybersecurity frameworks and audits
- Hardware procurement and onboarding systems
Deliverables
- Ready-to-use workspace (physical or hybrid)
- Secure IT and cloud access
- Business continuity and disaster recovery plans
Best Practice: Many GCCs adopt a cloud-first, remote-ready setup to accelerate early operations.
Phase 5: Leadership Hiring & Talent Acquisition (Weeks 9–18)
Why Leadership Comes First
The success of a GCC depends heavily on local leadership that understands both global expectations and regional talent dynamics.
Hiring Priorities
- GCC Head / Center Leader
- Engineering or functional leaders
- HR, finance, and operations managers
- Core delivery teams
Talent Strategy
- Mix of experienced hires and early-career talent
- Strong employer branding
- Competitive compensation and career paths
Deliverables
- Leadership team in place
- Initial delivery teams onboarded
- HR policies and performance frameworks
Best Practice: Start leadership hiring as early as possible, even before legal setup completes.
Phase 6: Process Alignment & Knowledge Transition (Weeks 13–20)
Objective of This Phase
This phase ensures the GCC operates as a true extension of headquarters, not a disconnected offshore unit.
Key Activities
- Process documentation and SOP creation
- Knowledge transfer from onshore teams
- Governance and escalation frameworks
- Tool standardization and reporting alignment
- Cultural and communication training
Deliverables
- Fully documented processes
- Trained delivery teams
- Defined governance cadence
Common Pitfall: Rushed knowledge transfer often leads to early delivery issues.
Phase 7: Pilot Operations & Go-Live (Weeks 18–24)
What Go-Live Really Means
Go-live is not the end – it is the beginning of stabilization and scale.
Key Activities
- Launch pilot projects
- Monitor KPIs and productivity
- Resolve early operational gaps
- Collect stakeholder feedback
- Finalize scale-up roadmap
Deliverables
- Operational GCC
- Performance dashboards
- Stabilization and growth plan
Best Practice: Use a phased go-live approach rather than launching all functions at once.
Key Factors That Influence GCC Setup Timeline
Several variables can significantly shorten or extend the overall GCC setup duration. Understanding these factors early helps enterprises set realistic expectations and avoid delays.
Operating model choice (BOT vs captive)
A Build Operate Transfer model often accelerates setup because a local partner manages early legal, hiring, and infrastructure tasks. A pure captive model offers full control but usually takes longer due to direct ownership responsibilities.
Hiring scale and skill complexity
Smaller teams with common skill sets can be hired quickly, while large-scale hiring or niche skills (Artificial Intelligence, cybersecurity, domain experts) extend timelines due to talent scarcity and longer recruitment cycles.
Regulatory speed and clarity
Countries with clear labor laws, faster entity registration, and predictable tax frameworks enable quicker setup. Regulatory ambiguity or lengthy approval processes can delay hiring and operations.
Leadership availability
Early appointment of a GCC head and functional leaders speeds decision-making, hiring and alignment with headquarters. Leadership gaps often slow execution across multiple setup phases.
Parallel execution maturity
Organizations that run legal, hiring, IT, and infrastructure workstreams in parallel reach go-live faster than those following a strictly sequential approach.
Experience with prior offshore centers
Companies with previous GCC or offshore experience already understand governance, compliance, and transition challenges, allowing them to avoid common mistakes and accelerate execution.
Organizations with prior GCC experience typically achieve go-live 30–40% faster than first-time builders due to proven frameworks, established partners, and mature operating playbooks.
Common GCC Setup Challenges
These challenges frequently impact GCC timelines and performance if not identified and managed early during the setup and transition phases.
- Delays in legal or tax approvals – Slow entity registration, tax structuring, or compliance clearances can block hiring and delay operational readiness.
- Talent competition in mature hubs – High demand for skilled professionals in established GCC locations increases hiring time, cost, and attrition risk.
- Cultural misalignment with HQ – Differences in work culture, decision-making styles, and communication can reduce productivity and trust.
- Underestimating transition complexity – Incomplete knowledge transfer and unclear processes often lead to early delivery issues post go-live.
- Overloading the GCC too early – Assigning too many responsibilities before stabilization can overwhelm teams and impact quality.
Proactively addressing these challenges significantly improves GCC stability, scalability, and long-term success.
Best Practices to Accelerate GCC Go-Live
These proven practices help enterprises reduce setup time, minimize risk, and achieve faster operational readiness during GCC establishment.
- Run legal, hiring, and IT tracks in parallel – Executing multiple workstreams simultaneously shortens the overall timeline and prevents dependency-driven delays.
- Hire leadership before infrastructure completion – Early leadership onboarding enables faster decision-making, team hiring, and alignment with headquarters.
- Start with pilot teams and scale gradually – Launching with small, focused teams allows early validation before expanding operations.
- Invest early in governance and communication – Clear governance models and communication channels prevent confusion and execution gaps post go-live.
- Leverage local partners for compliance and hiring – Experienced local partners accelerate regulatory processes and access to regional talent pools.
Common GCC Operating Models
These operating models define how a Global Capability Center is established, managed, and scaled based on ownership, control, and speed-to-market requirements.
- Captive Model – The GCC is fully owned and operated by the parent company, offering maximum control, IP security, and long-term strategic alignment.
- Build-Operate-Transfer (BOT) Model – A local partner sets up and runs the GCC initially, then transfers full ownership to the parent company after stabilization.
- Hybrid Model – Combines a captive core team with managed IT service partners to balance control, flexibility, and faster scaling.
Future Outlook: GCCs Beyond Go-Live
Modern GCCs are evolving from execution centers into strategic hubs that drive innovation, ownership, and enterprise-wide digital transformation.
- Product engineering and platforms – GCCs take end-to-end ownership of digital product development, platform modernization, and continuous innovation.
- AI and data science initiatives – GCCs lead advanced data analytics, machine learning models, and AI-driven decision-making at scale.
- Cybersecurity and cloud centers of excellence – GCCs centralize security, cloud governance, and resilience for global digital operations.
- Enterprise transformation programs – GCCs act as change engines, supporting large-scale digital, process, and operating model transformations.
Organizations that design GCCs for long-term ownership and innovation unlock significantly higher strategic and business value beyond go-live.
Quick Facts

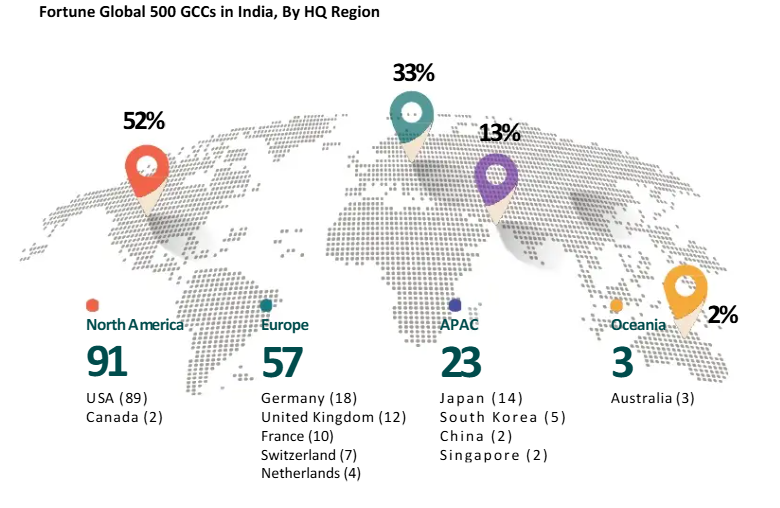

US companies account for the largest share of Fortune Global 500 enterprises operating Global Capability Centers (GCCs) in India, highlighting the country’s continued role as a preferred destination for global business operations, technology, and innovation.
Why India Is the Global Hub for GCCs?
India has emerged as the preferred destination for Global Capability Centers due to its unmatched combination of talent depth, delivery maturity, and cost efficiency.
- Deep STEM and engineering talent pool – India produces a large volume of highly skilled engineers, technologists, and digital specialists every year.
- Mature IT and startup ecosystem – Decades of IT services experience and a strong startup culture support innovation, scalability, and collaboration.
- Proven delivery at global scale – Setting up GCC in India consistently supports complex, mission-critical operations for Fortune 500 enterprises worldwide.
- Favorable cost-to-quality ratio – Organizations achieve high-quality outcomes while significantly reducing operational and talent costs.

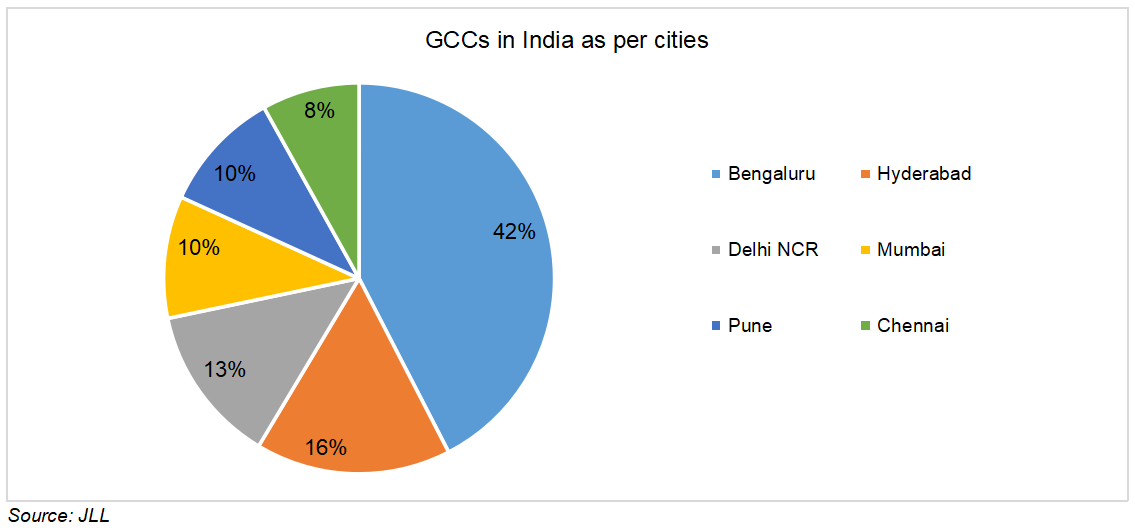

- Cities like Bengaluru, Hyderabad, Pune, and Chennai have become strategic GCC hubs along with the emerging cities like Ahmedabad and Kochi, leading the GCC market due to talent availability, infrastructure readiness, and strong business ecosystems.
Frequently Asked Questions
Can multiple GCC setup phases run simultaneously?
Yes. Most enterprises run several workstreams in parallel instead of waiting for one phase to finish before starting the next. This shortens the overall timeline while maintaining governance.
Typical parallel activities include:
- Legal entity registration
- Leadership hiring
- Office and infrastructure planning
- IT and security provisioning
- Vendor onboarding
What usually causes unexpected delays during GCC setup?
Several factors can slow a GCC launch if they're not identified early:
- Delayed company registration and statutory approvals
- Slow recruitment for leadership or niche technical roles
- Office lease or infrastructure readiness issues
- Incomplete knowledge transfer from headquarters
- Unclear ownership across global and local teams
How do you know when a GCC is ready for go-live?
Go-live is more than opening an office. A GCC is generally ready when its people, processes, technology, and governance are aligned to support business operations with minimal disruption.
Does the GCC operating model affect the implementation timeline?
Yes. Different operating models require different levels of ownership, investment, and execution effort.
|
Operating Model |
Timeline Impact |
|
Captive |
Longer setup due to direct ownership |
|
BOT |
Faster because a local partner manages initial setup |
|
Hybrid |
Balances implementation speed with operational control |
Should leadership hiring begin before the legal entity is fully established?
In most cases, yes. Strong local leadership often influences the success of every subsequent setup phase. Early leadership hiring helps organizations:
- Build the employer brand sooner
- Define hiring priorities
- Coordinate with headquarters
- Support compliance and operational planning
- Reduce delays during team expansion
What functions are usually transferred to a new GCC first?
Organizations rarely move every business function at once. They usually begin with well-defined teams such as engineering, finance, customer support, analytics, or shared services before expanding into product ownership and strategic functions.
How can enterprises reduce GCC setup risks without compromising compliance?
A structured governance model makes risk management much easier.
Good practices include:
- Finalize compliance requirements early
- Assign clear owners for every workstream
- Track dependencies through regular governance reviews
- Document processes before knowledge transfer
- Work with experienced local advisors where required
What happens after a GCC officially goes live?
Go-live marks the beginning of stabilization rather than the end of the project. During this phase, organizations typically:
- During this phase, organizations typically:
- Monitor operational KPIs
- Resolve early process gaps
- Gather stakeholder feedback
- Expand hiring in planned stages
- Prepare additional business functions for transition
Is setting up a GCC different for first-time enterprises?
Yes. Companies establishing their first GCC usually spend more time defining governance, selecting an operating model, understanding local regulations, and planning knowledge transfer.
How do organizations measure whether a GCC setup has been successful?
A successful launch is measured by more than meeting the planned go-live date. Enterprises typically evaluate:
- Hiring progress against targets
- Operational readiness
- Service quality and productivity
- Compliance and governance maturity
- Stakeholder satisfaction
- Ability to scale without disrupting business operations
